Parent and Child Projects

Some projects are too big to sit comfortably as one record. A rail corridor spanning dozens of sites, or a development with hundreds of plots to stake out, can end up with an unwieldy list of proposal items that's hard to review and painful for your team to navigate when logging time.


Parent and child projects let you break a large project into a collection of smaller, self-contained ones (grouped under a single parent) while still seeing the whole thing together where it matters.

Think of it exactly like grouping proposal items, but one level up: instead of grouping items inside a project, you're grouping whole projects under a parent.


When to use it

Consider a parent project when:


  • A single project has grown to hundreds or thousands of proposal items.
  • The work naturally divides into lots, phases, or sites that could each stand alone.
  • Different parts of the job are billed to different clients.
  • Different parts have different site locations and mapping information.
  • Your team struggles to find the right proposal item when recording timesheets, because the list is so long.

If none of those apply, a normal single project is still the simpler choice, you do not need to split every project.


How it works

  • A parent project can have any number of child projects.
  • Nesting is one level only. A child cannot itself have children, and a project that already has children cannot be turned into someone else's child. (No grandchildren.)
  • Each child is a full project in its own right: its own proposal items, its own tasks, its own timesheets, its own site address and mapping, and, if you need it, its own client.
  • The parent gives you a single place to see everything grouped together.

What a child has of its own

Aspect Behavior
Proposal items Each child has its own, kept separate from its siblings and the parent.
Client A child can be billed to a different client from the parent.
Site address & mapping Each child carries its own location and map geometry.
Tasks & timesheets Logged against the child, so your team only sees that lot's tasks.
Naming Name each child however suits, by lot, phase, area, and so on.

Setting it up

You link projects into a parent-child relationship by setting a project's parent. There are two natural ways to work:


Option 1: create the children, then group them. Create each lot as its own project as you normally would, then set the parent on each one to point at the project you want to act as the parent.


Option 2: start from the parent. Create (or pick) the project that will act as the parent, then create each child and set its parent to that project.

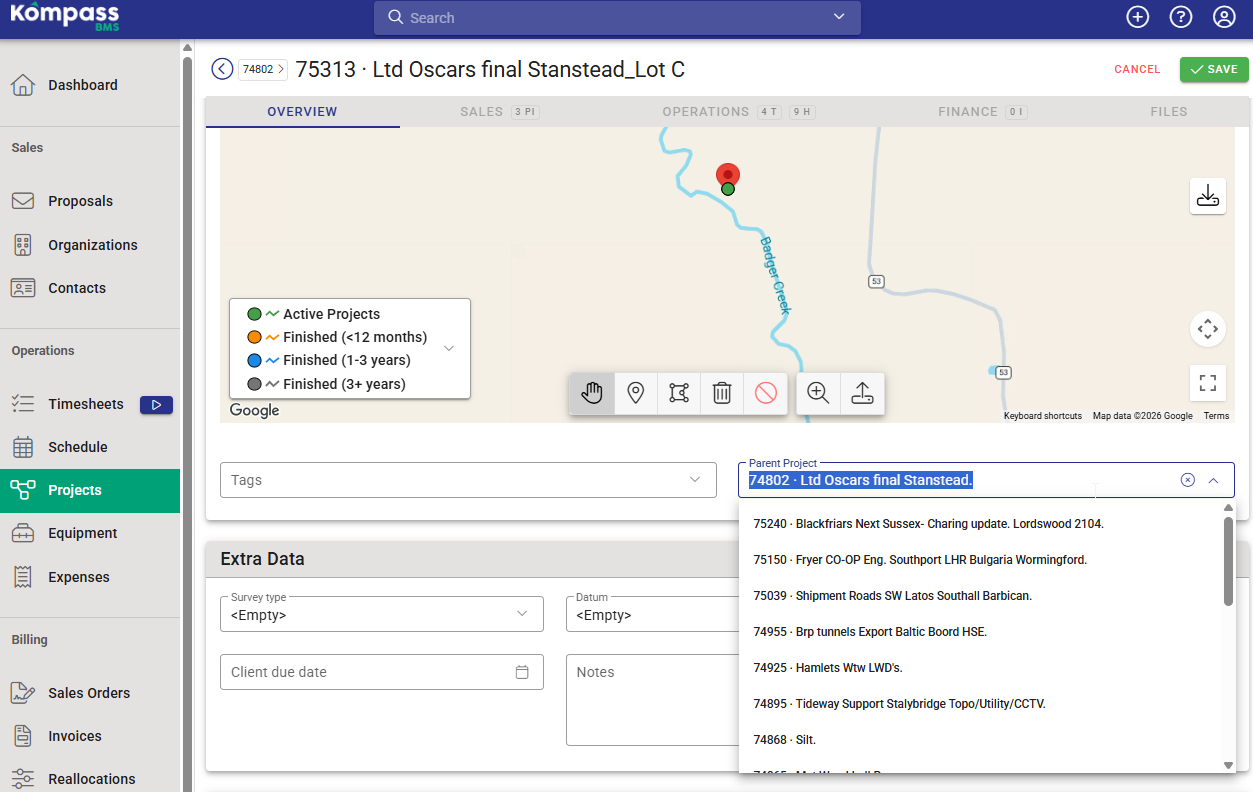

Either way, the key action is the same: on a project, set its Parent to the project that should sit above it. To detach a child again, simply clear its parent.


The rules Kompass enforces

To keep the grouping sensible, Kompass checks a few things when you set a parent. If one isn't met, you'll see a message explaining why.


  • One level only. You cannot set a parent that is itself a child, and you cannot give a parent to a project that already has children of its own.
  • A project cannot be its own parent.
  • Same organization. A parent and its children must belong to the same organization. A child can use a different currency from its parent. If you need to move a project to another organization, detach it from its parent (or move or detach its children) first.
  • Stage order. An active child cannot sit under a parent that is already further along than it. For example, you cannot attach an in-progress child to a parent that has already been delivered or invoiced.  You would need to reopen the parent first. Proposals are more relaxed: a proposal that has not been accepted can sit under a parent at the quote or active stage, but not under one that is already finished or closed.
  • Accepting a child proposal. Following on from the stage rule: if a child has not been accepted yet, you cannot accept it while its parent is already finished or closed. Reopen the parent first.

Note: deleting is protected too. A parent that still has children cannot be deleted until those children are reassigned to another parent, detached by clearing their Parent Project field, or deleted first. This is deliberate, so you never lose track of a child by removing its parent out from under it.



How acceptance flows up

A parent project's accepted status can come from its children. If a parent has no accepted proposal items of its own, it takes its acceptance from the earliest accepted child. In other words, as soon as the first child is accepted, the parent is considered accepted from that date.


If the parent has its own accepted proposal items, those take precedence and it does not derive anything from the children.


You do not need to do anything to make this happen. Kompass keeps it in step automatically as children are accepted, reopened, attached, or detached.


Viewing parents and children in the list

The Projects and Proposals lists can show parent and child projects in two ways. To switch, click the list button at the top right of the list, next to the map button, and choose Tree view or Flat list.

The list button's menu with Flat list and Tree view

  • Tree view (the default) shows each child directly under its parent, indented, so a whole job reads as one group.
  • Flat list shows every project on its own row, sorted with the rest. A child shows a chip that links to its parent, and a parent shows a chip that lists its children.

Kompass remembers your choice in this browser, separately for each Org. It is not part of a saved filter.

Tree view

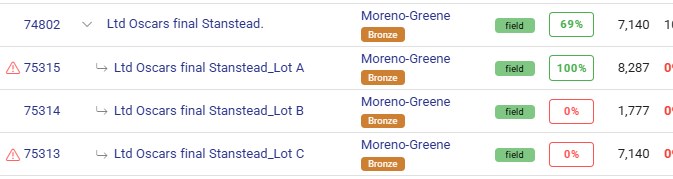

A collapsed parent project with group figures, and an expanded parent with its two children indented beneath it

  • Collapse or expand a parent with the arrow in front of its ID. Kompass remembers which parents you collapsed.
  • A parent always shows its own figures, whether it is collapsed or expanded. When it is collapsed, a gray group line under each figure shows the total for the parent and its children: price, accepted price, hours, the hours percentage, invoiced, paid, unpaid, WIP, and the status percentage. Hover over a group figure to see how many child projects it includes. Children hidden by your current filters still count toward these totals. Where several child proposals are alternatives for the same project, only one of them is counted, so the total is not doubled (see Quotes for the same project).
  • A parent and its children stay on the same page. Only the top-level rows count toward the page size and the number of projects shown, so a page can hold more rows than the page size.
  • A parent whose children are all hidden by your filters has no arrow. Its children chip still lists them.
  • Starting or changing a search expands every parent, so you can see the matching children. If you collapse a parent during a search, that only lasts until you clear the search; your saved collapsed parents then come back. A matching child whose parent does not match the search appears on its own row, with a chip linking to its parent.
  • On a phone, each card shows the project's own figures only, without the group totals.

The payoff for your team

The biggest day-to-day win is for the people recording their time. Instead of scrolling through an enormous single list of proposal items to find the right one, they only see the proposal items for the specific child project (lot) they're working on. Smaller lists, less hunting, fewer mistakes.


And for whoever is managing the work, the parent gives you the bird's-eye view, the whole job's totals in one place, without losing the ability to drill into any single lot.
