Record project status

This tutorial explains how to record the status of a project at certain dates.

Note: Kompass form field labels can be customized for different Kompass instances. Therefore, it is likely that some fields will be named differently in your version of Kompass.

TABLE OF CONTENTS

Step 1a: Recording Project Status - Rate Proposal Items

  1. WHICH? (Find the project): From the "Projects" list page, search for the project you want to update, and click the status pill in the "Status" column. For a project with rate items the pill reads "Rate"; a project with both rate and lump sum items shows a percentage and "Rate".

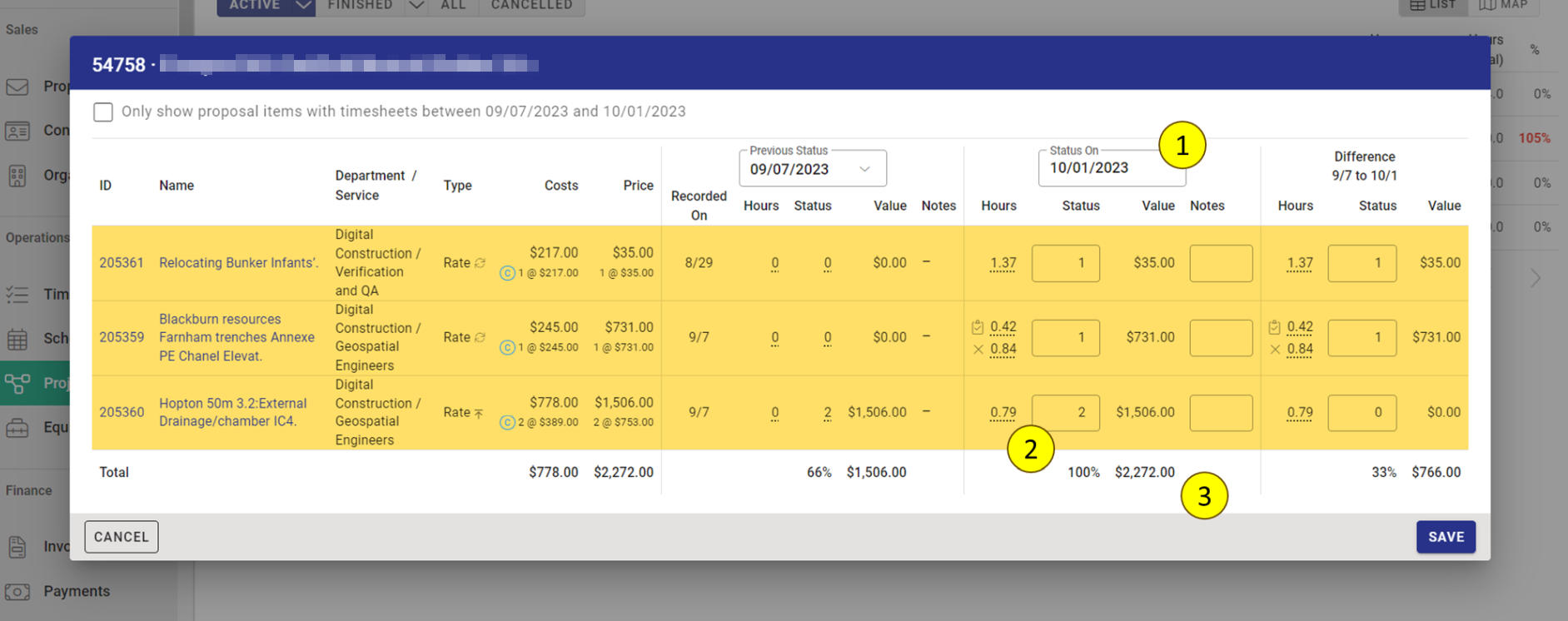

  2. WHEN? (Set the status date): Select the date in the "Current" date picker at the top of the status table. The status is recorded on that date when you click "Save".
  3. WHAT? (Works completed on the status date): Enter how many units of each Proposal Item have been completed up to that date in the "Status" column. The "Value" column shows the value at that status, and the "Difference" columns show the change since the previous status. The totals row at the foot of the table shows the previous and current totals and their difference.

    Alternatively, enter the change since the previous status in the "Difference" column. The current status updates to match.

Step 1b: Recording Project Status - Lump Sum Proposal Items

  1. WHICH? (Find the project): From the "Projects" list page, search for the project you want to update, and click its status pill in the "Status" column. For a project with lump sum items the pill shows the percentage of completion.

  2. WHEN? (Set the status date): Select the date in the "Current" date picker at the top of the status table. The status is recorded on that date when you click "Save".
  3. WHAT? (Works completed on the status date): Enter the estimated percentage of completion for each Proposal Item on that date in the "Status" column. The "Value" column shows the value at that status, and the "Difference" columns show the change since the previous status.

Step 2: Browsing Older Status Records

  • Retrieve older status records by choosing a date from the "Previous" list at the top of the status table.


  • The "Previous" columns show the latest status recorded on or before the previous date, the "Current" columns show the status on the selected date, and the "Difference" columns show the change between the two.

    Change the date in the "Current" date picker to calculate differences between status updates. Previous status records are marked with an orange dot in the calendar.


You can find extensive information about all columns in the project status window in the Reference article Project Status. You will also find troubleshooting articles explaining all Kompass warnings that might appear while recording your project status.

Step 3: Adding notes to your status updates

When recording a status update, you may need to add notes to explain the reasoning or communicate with other teams in your organization. For instance, the project manager can instruct finance on how much to invoice for a proposal item using the "Notes" column. You can save a note for each status update of each proposal item. Click "Save" to store the notes.

Summary

This guide explains how to record proposal item status and how to read the columns in the status window.
